Build your first deApp
Let’s consider the following idea of the conceptual dApp consisting of two smart contacts: aCounter
smart contract residing in one chain, where the
integer property (counter
) is stored and can be incremented by a call initiated by and only by the Incrementor
contract from another chain. In other
words, when we perform some action against the Incrementor
contract, it initiates a cross-chain transaction (a submission, in terms of the deBridge
protocol) which is being started on one chain, relayed to, and then executed on another chain; during this cross-chain transaction, a Counter
contract

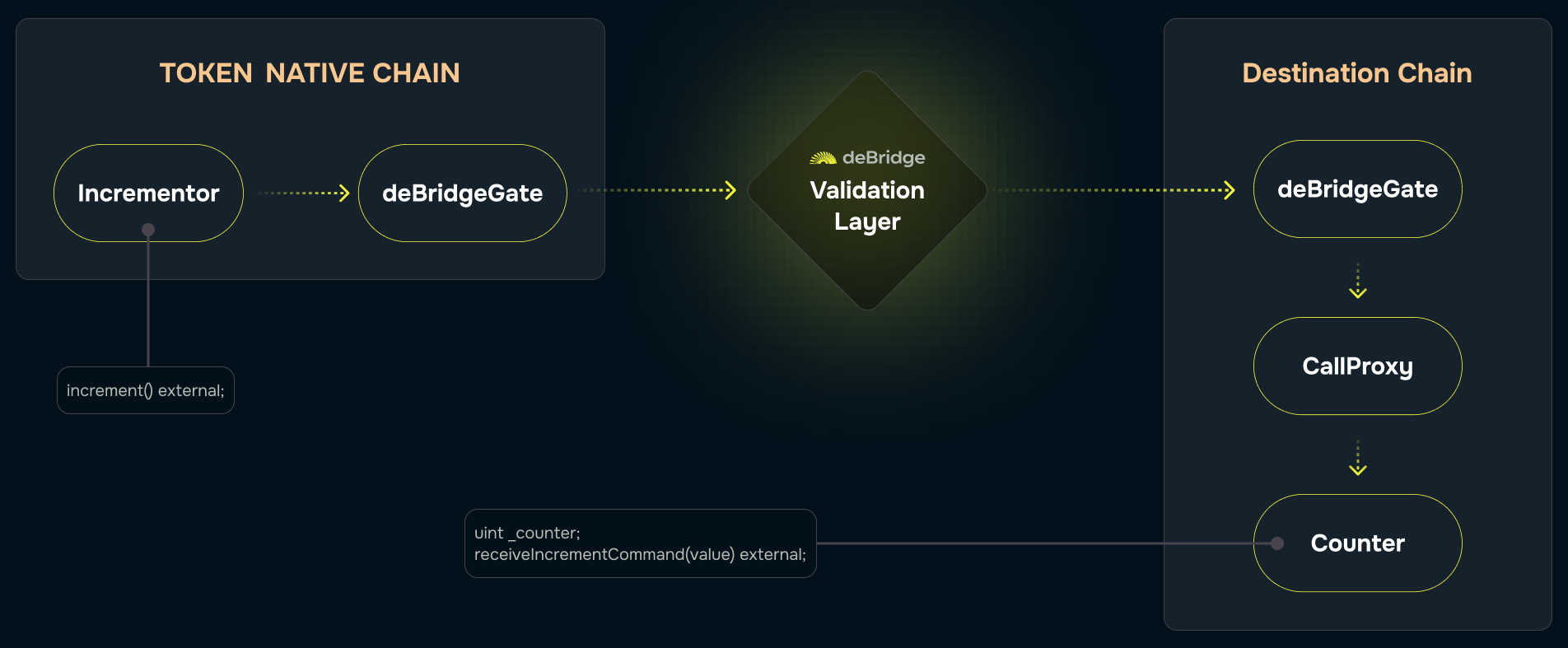

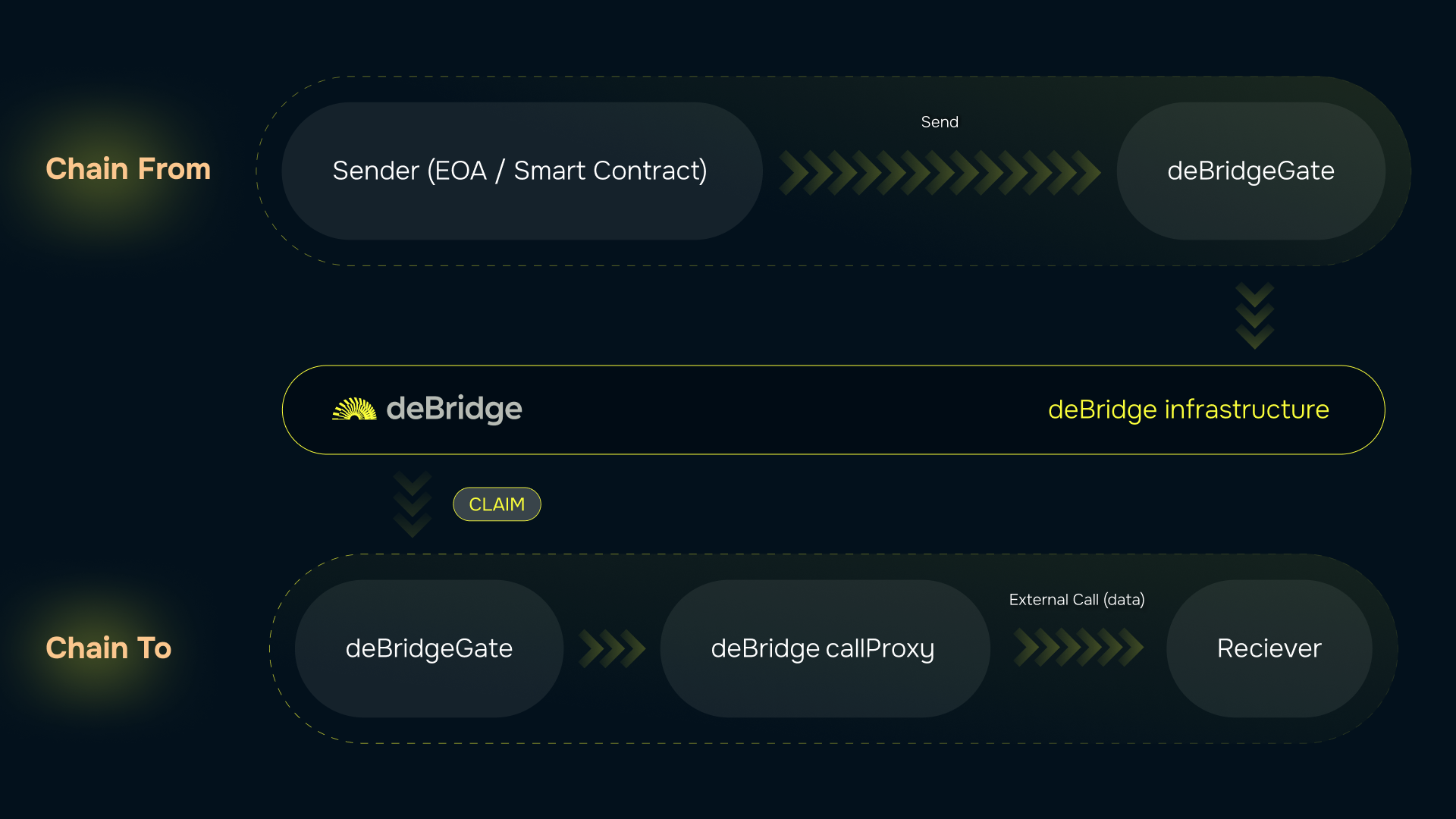

is called. The following image presents a high-level overview of a cross-chain transaction we are going to achieve:

Making the Counter contract
Let’s start with making the counter contract, responsible for keeping the integer property and accepting calls to increment it. Obviously, there should be a property and a method:deBridgeGate
smart
contract only, and second, this call should occur only during the cross-chain transaction originating from the Incrementor
smart contract at the
specific address on another chain. How can this be achieved?
The cross-chain transaction is a message from the origin chain with a payload that includes (among other info) the packed address of the initiator
(nativeSender
) - i.e. an entity that actually initiated the transaction by calling the deBridgeGate
contract on the origin chain. When the cross-chain
transaction is being relayed, the deBridgeGate
contract on the destination chain temporarily exposes the state of the transaction it currently handles
via its properties and then calls a target smart contract (whose address is also a part of a payload) through its helper intermediary. It means that
the contract on the target address may access this data.
To make this happen, the Counter
must know the deBridgeGate
contract’s address on the current chain, so it is reasonable to inject it via a constructor:
receiveIncrementCommand
method using a modifier. The first obvious check we must perform is to ensure
this method is called by the deBridgeGate
’s helper intermediary - a CallProxy
contract responsible for performing actual calls (the deBridgeGate
contract doesn’t make calls directly for security considerations):
deBridgeGate
handles some cross-chain transactions relayed from another chain.
The not-so-obvious second check is related to our business logic: we want to ensure that a transaction is originating from the chain we know and from
the contract we trust. To make such validation happen, we must preliminarily store the trusted address in the Counter
contract, for example like this:
Note that we store the packed version of the caller’s address (mind that
trustedCrossChainCaller
is defined as bytes rather than the address): this
happens because the deBridgeGate
smart contract stores the byte representation of the native sender address to ensure future compatibility with
non-EVM chains (e.g. Solana).Incrementor
contract and get its address, we may let the Counter
contract know about it by calling the addChainSupport
method.
As soon as the Counter
contract starts storing the caller’s address, the cross-chain transaction is allowed to originate from, we may reuse this data
and add the additional validation logic to the modifier:
receiveIncrementCommand
method, it becomes properly protected from unauthorized calls and
ready to receive commands from the trusted contract on another chain:
Making the Incrementor
contract
Now after we have the Counter
contract and know its interface, we may design the Incrementor
contract, which is responsible for initiating the
cross-chain call to Counter
’s receiveIncrementCommand()
. First things first, we must let the Incrementor
know where the Counter
contract actually
resides, so we inject it with the chain ID and address of the Counter
contract, and we also specify the address of the deBridgeGate contract as well:
deBridgeGate
’s send()
method — the only entry point to initiate a
transaction. It accepts plenty of non-trivial variables and structs. Let’s overview all of them to make our submission happen.
A protocol fee
Worth mentioning that thesend()
method is marked as payable
(meaning that it accepts ether during a call) and it is necessary to bypass enough
ether to cover the protocol fee (or global fixed native fee, according to the internal definition) taken in the native currency of the chain. How
much? The fee varies from chain to chain: for example, at the time of writing the fee on Ethereum is 0.001 ETH and the fee on Polygon is 0.5 MATIC.
Since fees can be changed by deBridge governance and are expected to be reduced as protocol scales, you are advised to retrieve the actual fee amount
by reading deBridgeGate
’s globalFixedNativeFee
property either on-chain:
Submission params
The gate accepts a variety of parameters through theSubmissionAutoParamsTo
struct (see its
definition), so it is important to
understand each.
executionFee
(or included gas) is the amount of the bridged asset that will be transferred to anyone who will deliver the message in the destination
chain. In other words, this is a prepayment for potential gas expenses on the target chain, that will be transferred by the protocol to the address
that claims the message. Anyone can run the keeper service to deliver messages and earn the executionFee. This is an advanced topic that runs out of
the scope of this document, so for the sake of simplicity just set this value to zero.
flags
is a bitmask of toggles affecting the
behavior of the gate. The following flags are important to be set in our case:
REVERT_IF_EXTERNAL_FAIL
tells theCallProxy
to revert the whole claim transaction in case the call to the receiver address (the callee contract on the destination chain; it is theCounter
contract in our case) fails. Select the proper behavior wisely, ensuring it is aligned with the design of the callee contract: for example, the contract may fail deliberately and irretrievably so it may be reasonable to handle this call gracefully and mark the whole cross-chain transaction as succeeded. Keep in mind that once the claim transaction succeeds itsubmissionId
is marked as used, so you cannot replay the transaction on the destination chain.PROXY_WITH_SENDER
tells theCallProxy
to expose the address that initiated the cross-chain transaction (submission) on the origin chain. Again, choose wisely: as for our case, theCounter
contract expects this data, so we need to ensure it’s presented on the destination chain.
A complete list of flags with their description can be found on EVM smart contract interfaces page.
fallbackAddress
is the address on the destination chain where the bridged funds will be transferred to in case the call to the receiver address fails
and REVERT_IF_EXTERNAL_FAIL
is not set. Since we don’t bridge any funds (only the calldata), this field is not very important though it is mandatory
to set it. Mind that this address must be packed into bytes.
data
is the field for the calldata
to execute on the destination chain. Not a big deal if the contracts reside on different chains: we can encode the
call using the interface of the contract to call. In our case, we can import the interface of the Counter
(ICrossChainCounter
) and use it with the
encodeWithSelector
to produce valid instructions aligned with the interface of Counter
’s receiveIncrementCommand
method:
autoParams
struct with settings that suit our needs:
autoParams
struct either on-chain (as in the example above) or off-chain using ethers.js or web3.js.
The send()
args
The last major step towards successful submission is the understanding of args of the send() method.
_tokenAddress
is the address of the ERC-20 token contract whose tokens you are willing to bridge additionally along with thecalldata
. If you are willing to bridge the native currency (e.g. ETH from Ethereum), use the zero address (address(0)
)._amount
is the amount of tokens (of the contract specified in the first arg) you are willing to bridge. Dealing with bridged assets is an advanced topic which out of the scope of this document, so in this example, it is enough to set this arg to zero. The following things are worth mentioning: first, the gate cuts a small 0.1% fee off the bridged asset; second, if you bridge the native currency of the origin blockchain, you must not forget to supply an additional amount to cover the protocol fee, but not include it in this arg value; third, the aforementionedexecutionFee
(included gas) is counted in the currency of this bridged asset, so its decimals must be in sync with this asset; fourth, ERC-20 tokens should not be transferred in/out explicitly, use allowance andsafeTransferFrom
instead._chainIdTo
sets the destination chain ID. Consider looking at chainlist.org for known chain IDs, see the list of supported chains in our docs, or querydeBridgeGate.getChainToConfig
on-chain property for programmatic access to the list of chains supported by deBridge._receiver
defines the address on the destination chain to receive bridged assets (if any) and be called by theCallProxy
contract in case the call data is given. In the given example, we must set this arg to the address of theCounter
smart contract._permit
allows the caller to specify EIP-2612-compliant signed approval for thedeBridgeGate
contract to transfer the tokens specified in the first arg. Not applicable here._useAssetFee
allows paying the protocol fee in the currency of the asset being bridged rather than the native currency of the blockchain. Not applicable here._referralCode
is used to mark the submission with your own code, which will be used later._autoParams
is the encodedautoParams
struct we’ve crafted in the previous chapter.
If you integrate with or build applications on top of the deBridge infrastructure, make sure you specify your referral code that can be generated by
pressing the WAGMI button at https://app.debridge.finance/. Governance may thank you later for being an early
builder.
_chainIdTo
, _receiver
and _autoParams
. The snippet that actually makes a call to the deBridgeGate
contract may look like this:
deBridgeGate
is made within a blockchain, the
cross-chain transaction is being initiated.
Accompanying and finishing a submission
Consider reading the Lifecycle of a cross-chain call to get yourself familiar with how the cross-chain calls
are handled.
Incrementor
in our case) submits a new cross-chain call, the deBridgeGate
contract emits a Sent
event containing all
necessary details about the cross-chain call, including the submissionId
— the global cross-chain identifier of such a call. The submissionId
is
the important thing to identify our submission, so we must capture it either by parsing the event manually or using deBridge SDK
(deSDK) which does this action for us:
Checking the status of the submission
The submission gets accepted by the validators after a transaction (containing the cross-chain call has been submitted) receives 12 block confirmations (256 for the Polygon chain). This is a required transaction finality validators are waiting for to avoid the consequences of the network divergence. You can monitor the finality of the transaction in a few ways: either using the preferred library (web3.js, ethers.js, or whatever) or with a little help of deSDK:Pulling signatures
After the origin transaction receives enough block confirmations, we may start pulling the signatures. Currently, signatures are available through the deBridge API: you can query them manually by calling the API directly, or use deSDK which additionally checks if enough signatures have been published already:Crafting transactions to claiming a submission
After the submission has been confirmed and signed by enough validators, it’s time to craft a claiming transaction that will land down the submission and execute the message on the destination chain. To claim a submission, a call to thedeBridgeGate.claim()
method on the destination chain must be crafted using the data from taken from various
sources, which isn’t an easy task, so there is deSDK which takes the burden of data
preparation:
deBridgeGate.claim()
method, and finally sign and broadcast your transaction and wait for the Claimed
event. This
will indicate a successful submission completion.
Keep in mind that estimating gas for such transaction may have undesirable pitfalls that we have covered in our small research - this may be the case
if you turn off the
REVERT_IF_EXTERNAL_FAIL
flag. We recommend using professional transaction simulation services (offered by Tenderly or Blocknative)
rather than calling your RPC’s eth_estimateGas
endpoint.Further reading
- Consider using the debridge-hardhat plugin for Hardhat to test your contracts on the emulated environment
- Find the source code of the example project examined in this document, along with tests and helper commands.
- Start using deSDK to send, track and claim submissions programmatically
- Watch the walkthrough video on how to use deBridge emulator for your development environment:
- Gathering data for the claim
- deBridge protocol flags explained (coming soon)
- Transaction bundling explained (coming soon)
- Execution fee explained (coming soon)
- Bridging arbitrary assets explained (coming soon)
